| Hours-of-work assessment | Documented by vendor | Analyses rosters and work-rest periods for indicative fatigue exposure. Assessment scope |
|---|
| FAID and KSS outputs | Depends on scope | Model output availability depends on the purchased option; the two models have distinct sensitivities. USD licence and support price listModel warning |
|---|
| Time-zone calculations | Depends on scope | Time-zone and crew-augmentation options require explicit edition and configuration confirmation. Product variants and optional outputs |
|---|
| Roster comparison | Documented by vendor | The product supports examining work patterns and fatigue tolerance settings; thresholds require organizational interpretation. Product variants and optional outputsAssessment scope |
|---|
| Third-party integration | Depends on scope | A separately quoted Shared Object Library is offered for scheduling-software integration. Enterprise and integration variantsUSD licence and support price list |
|---|
| Desktop and web trials | Documented by vendor | The free web trial analyses one person/roster for up to seven days of data; the time-limited desktop trial analyses up to three weeks for three people/rosters. Free trial scope |
|---|
| Planned-versus-actual schedule comparison | Depends on scope | The official FAQ says FAID Quantum can compare multiple IDs representing people, groups or shift patterns across two work schedules, often planned and actual, and report hours above tolerances plus peak results and distributions. Confirm edition limits, roster alignment, changes and missing shifts, identifier mapping, comparison period, filters and export; a difference in predicted exposure does not establish why actual work differed or whether an individual was impaired. Official FAQ covering models, inputs, imports, history and planned-versus-actual comparison : checked 29 September 2026 |
|---|
| Configurable tolerance levels and task-risk bands | Depends on scope | FAID and KSS conditions are calculated relative to configured FAID and KSS Tolerance Levels, with optional Low, Moderate or High Task Risk input when multiple tolerances are used. These are organizational settings, not universal safe-work limits. Define governance, evidence, competent approvers, versioning, exceptions and the response required for each condition; never treat Green as fitness-for-duty clearance. FAID and KSS tolerance conditions, compliance percentages and peak-colour interpretation : checked 29 September 2026Official FAQ covering models, inputs, imports, history and planned-versus-actual comparison : checked 29 September 2026 |
|---|
| Manual, template and spreadsheet roster input | Depends on scope | The FAQ documents direct single or cycle shift entry, predefined shifts and spreadsheet copy-and-paste, with compulsory ID, Start and End plus optional task risk, origin, destination, activity and locations. Roster, Enterprise and customized variants can directly import third-party extracts. Validate locale, date and time parsing, time zones, daylight saving, overnight shifts, duplicates, gaps, identifier privacy, rejected rows and reconciliation to the source roster. Official FAQ covering models, inputs, imports, history and planned-versus-actual comparison : checked 29 September 2026FAID Quantum version 1.1.1 user guide : checked 29 September 2026 |
|---|

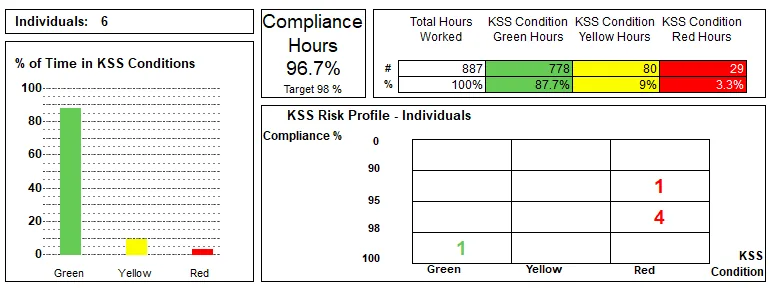

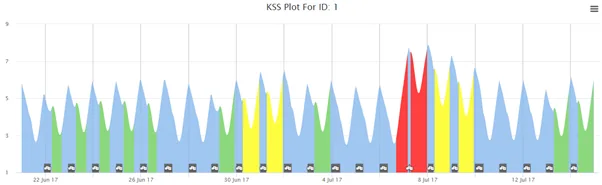

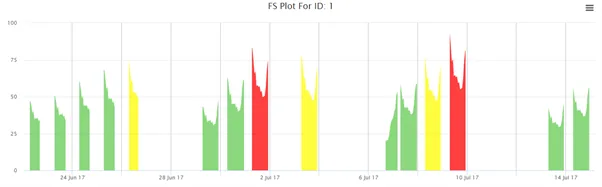

| Condition, peak and distribution reporting | Depends on scope | FAID Quantum reports graphical and tabular results, peak FAID and KSS values, time in Green, Yellow and Red conditions and percentages relative to configured tolerances. The condition guide warns that a shift colour reflects the peak condition reached and does not mean the whole shift remained in that condition. Confirm denominators, rounding, missing data, timezone presentation and retained assumptions before using summaries in management decisions. FAID and KSS tolerance conditions, compliance percentages and peak-colour interpretation : checked 29 September 2026FAID Quantum overview and interpretation guide : checked 29 September 2026 |
|---|
| History-dependent fatigue calculation | Depends on scope | InterDynamics states that the fatigue calculation requires one week of prior history; analysing a week therefore requires two weeks of supplied roster activity, and no results are provided for the first history week. Confirm equivalent requirements for the selected model, actual-sleep option, time-zone configuration and edition. Detect truncated imports and do not interpret absent initial output as low exposure. Official FAQ covering models, inputs, imports, history and planned-versus-actual comparison : checked 29 September 2026 |
|---|
